commercialheatpumpinstallation
UK COMMERCIAL HEAT PUMP INSTALLATION GUIDE

Commercial heat pump installation in the UK: design, cost and tax relief

A UK guide to commercial heat pump installation: the heat-loss survey, flow-temperature design, DNO capacity, acoustic sign-off and commissioning that decide whether a system holds temperature when it matters.

4-12 wks
Typical on-site install
No lost heat
Phased boiler cutover
Checked
Commissioning to design
Commercial heat pump installation — cascaded air-source units and plant-room pipework on a UK site

The six install types are covered in commercial air source heat pump installation, commercial ground source heat pump installation, water source heat pump installation, hybrid heat pump installation, high temperature heat pump installation and heat network installation. On money, see commercial heat pump cost, heat pump capital allowances and the heat pump cost calculator uk. Common misconceptions are checked in commercial heat pump myths, and the installation FAQs answer the questions that come up most.

WHY THE INSTALL IS THE HARD PART

The kit is easy. Delivering heat on the coldest day is the engineering

A commercial heat pump installation is an engineering project first and a product purchase second. The kit is the easy part; what separates a system that holds temperature through a January cold snap from one that trips to backup and burns gas anyway is the delivery. That starts with a proper heat-loss survey and at least twelve months of consumption data, runs through flow-temperature design and emitter compatibility, the electrical supply capacity the added load needs from the DNO, the acoustic assessment (BS 4142) and any planning consent for external plant, and a phased changeover that never leaves the building without heat. Air-source, ground-source, water-source, hybrid and high-temperature systems are installed across UK commercial and public-sector buildings, and the design risk is lowest when the whole chain, survey to commissioning, is planned together rather than a heat pump being dropped off and the design risk left with the building owner. The £7,500 Boiler Upgrade Scheme can reach small non-domestic buildings (up to 45 kWth), but larger plant needs a different funding playbook, and that too is part of getting the install delivered rather than stalled.

  • Every system is sized from a heat-loss survey and twelve months of consumption data, so it holds temperature on the coldest day, not just on the spec sheet.
  • Emitters are surveyed before the design, so there is no strip-out that is not needed and no surprise mid-install.
  • The DNO supply capacity is checked at survey and any upgrade started at feasibility, because the grid, not the heat pump, is usually the longest-lead item.
  • The BS 4142 acoustic assessment is produced and the planning route confirmed before the plant is ordered, so a noise complaint is less likely after commissioning.

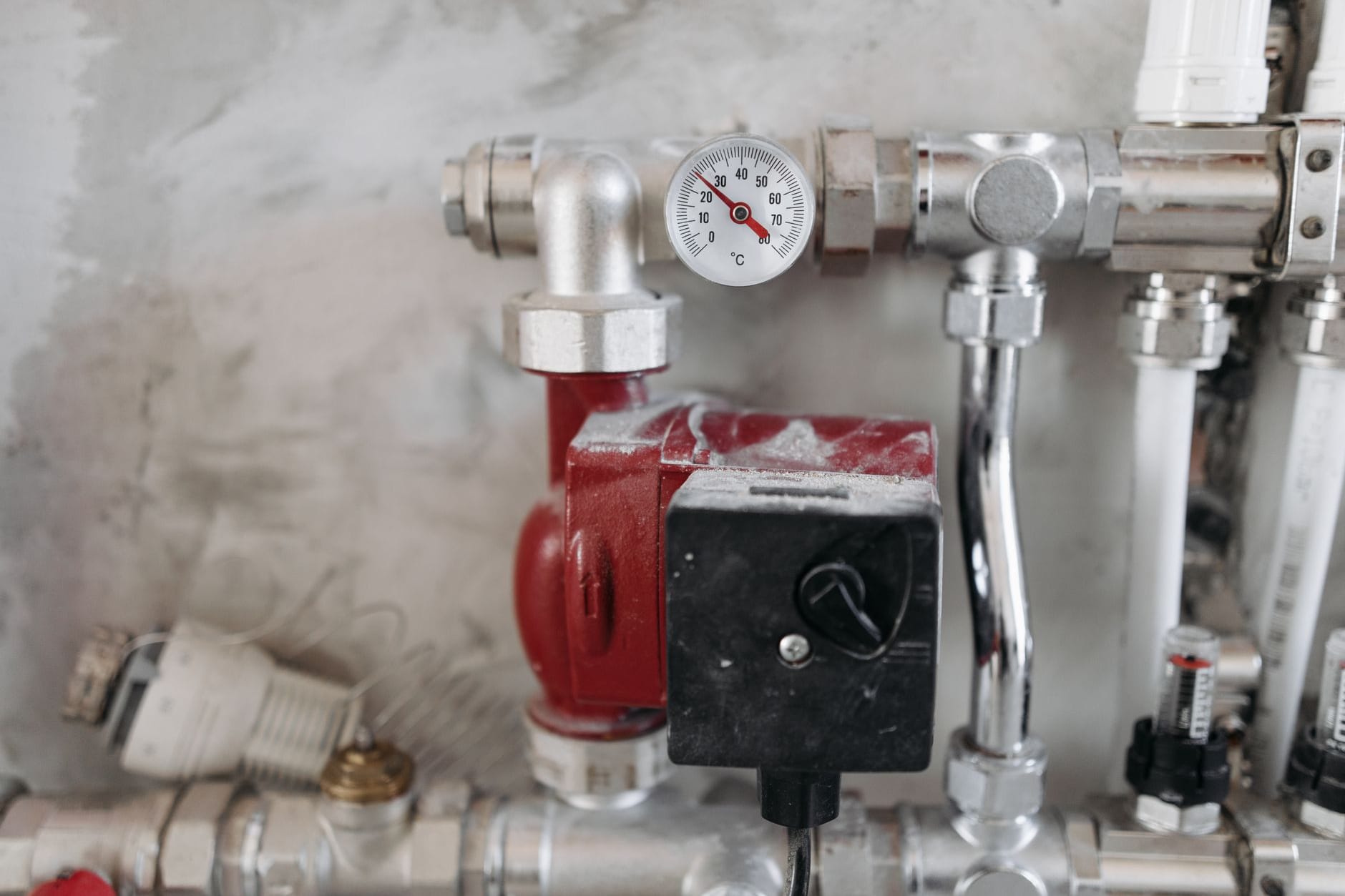

Heating plant room with insulated pipework and buffer vessels for a commercial heat pump
WHAT ACTUALLY DECIDES THE PROJECT

The install runs on four gates: survey, flow temperature, supply, commissioning

45-55°C
Design flow temperature
Lower flow temperature lifts the SCOP
12 months
Consumption data reviewed
Sized from real load, never floor area
DNO
Supply capacity checked
The added load, confirmed at survey
BS 4142
Acoustic assessment
Settled before the plant is ordered
HOW THE INSTALL RUNS

From heat-loss survey to commissioning witnessed by the client

A single point of responsibility across survey, flow-temperature design, DNO capacity, acoustic and planning, phased install and testing.

  1. 01
    Week 1-2

    Heat-loss survey & data

    A heat-loss survey and at least twelve months of gas or oil consumption set the size of the system, so it is sized from real load rather than a rule of thumb.

  2. 02
    Week 2-6

    Design, emitters & DNO

    The emitters are surveyed, the design is set to the lowest workable flow temperature for the best SCOP, and the electrical supply capacity is confirmed, with any DNO upgrade started early.

  3. 03
    Month 2-4

    Acoustic, planning & freeze

    The BS 4142 acoustic assessment is produced and the planning route confirmed with the local planning authority before the design is frozen and any plant is ordered.

  4. 04
    Install 4-12 weeks

    Phased install & commissioning

    The install is phased around the operating calendar, the existing boiler stays live as backup through commissioning, then the system is checked to its BS EN 14825 design and the O&M pack handed over.

The commercial case, honestly

An installed heat pump is owned plant, and a hedge against gas

A correctly engineered install is what turns the case into cash. Heat-pump plant sits on your balance sheet: because it commonly forms an integral feature of the building it falls in the special-rate pool, so the primary tax lever is the Annual Investment Allowance, 100% relief on up to £1m of qualifying spend a year (not full expensing). Installed cost depends on capacity, emitters, supply and siting; see the cost guide. The running-cost case is decided by the SCOP, which is why the design aims for the lowest workable flow temperature and is modelled against real consumption.

Running cost, on a real SCOP

Electricity costs more per unit than gas, but a well-designed system delivers 3-4 units of heat per unit of electricity. Running cost should be modelled from actual consumption and the electricity tariff, at a low flow temperature, so the numbers are honest before any spend.

Why start the survey now

The DNO supply upgrade, where one is needed, is often the longest-lead item, and any grant window has fixed deadlines. Starting the survey and the connection conversation early is what keeps a funded scheme deliverable.

What a good proposal includes

An itemised proposal, a commissioning pack proving the SCOP, and a planned O&M regime. A desk assessment should say honestly if a building does not yet suit a heat pump.

WHY A SPECIALIST INSTALLER

Specialist heat-pump installer vs a general heating contractor

Specialist heat pump engineer
Ask to see the certificates
General heating contractor
Broad remit, boiler-focused
Equipment supplier only
Sells the kit, not the install
Heat-loss survey & 12-month data Sometimes
Flow-temperature & emitter survey
Confirms DNO supply capacity Sometimes
BS 4142 acoustic assessment
Refrigerant work by F-Gas-regulated engineers Sometimes
Phased cutover, boiler kept live Sometimes
Commissioning checked to BS EN 14825
COMMON QUESTIONS

Installation questions answered

Straight answers on timelines, emitters, electrical supply, acoustic and commissioning — the things that actually decide a heat-pump project.

How long does a commercial heat pump installation take?

An air-source retrofit is typically 4-12 weeks on site once design and any DNO supply work are agreed, and the live boiler cutover is usually a matter of hours. Ground-source and water-source take longer because of drilling, ground works and permits, often several months. Industrial, process and heat-network schemes run to 12 months or more including design, planning and grid works. The DNO supply upgrade, where one is needed, is frequently the longest-lead item, which is why it is started at feasibility rather than install week.

Does the building have to shut down or lose heat during the install?

No. The changeover is best planned around the building's operating calendar, typically spring or autumn, and for a hybrid or phased design the existing boiler can stay live as backup right through commissioning, so the building is not left without heat. Air-source plant is largely pre-assembled, so the live cutover is a matter of hours. Every tie-in is method-statemented and agreed with the site before works begin.

Do all the radiators and pipework have to be replaced?

Often not. Surveying the emitters before anything is designed shows what is needed. Many commercial systems run a heat pump at 50-55 C with selective emitter upgrades rather than a full strip-out. Where high flow temperatures are genuinely needed, a high-temperature heat pump (70 C+) or a hybrid design with a peaking boiler avoids re-emittering the whole building while still cutting carbon 70-90%.

How do you size a commercial heat pump?

From a heat-loss survey and at least twelve months of gas or oil consumption, never from floor area. Sizing sets the peak heat load and the flow temperature the emitters allow, because a lower flow temperature lifts the SCOP. Typical commercial air-source systems land between 40 and 500 kW thermal; ground and water-source 50 kW-1 MW+; industrial and heat-network schemes larger again. Specifying to BS EN 14825 makes quoted performance comparable across suppliers.

Will the electricity supply cope with the added load?

That is checked at survey, before anything is ordered. Large heat pumps add meaningful electrical load, so the available incoming supply capacity should be confirmed, and where a DNO supply upgrade is needed it is started at feasibility because it is often the longest-lead item. On constrained sites, phasing, hybrid designs or demand management can keep the project within capacity.

Is planning permission and an acoustic assessment needed?

Planning for external plant depends on the local planning authority, the building's use class, the siting and the noise, so check the Planning Portal and the council before ordering. A BS 4142 acoustic assessment is commonly used to show the external plant will not disturb neighbours, and it is best completed before the plant is ordered. Listed buildings and conservation areas need consent, and ground-source or water-source schemes may need planning and an Environment Agency permit. All of this is confirmed at feasibility.

Request a commercial heat pump quote

Replies by email

  • 1. Desk feasibility from the building details and consumption data you send, no obligation.
  • 2. A plain assessment of the flow temperature and supply questions.
  • 3. Next steps laid out plainly, with no obligation.

By submitting you agree to our privacy policy. We never sell your details.

Request a quote
Request a quote
